How to Import Project Data From MS Excel File

You can import information into the project from MS Excel workbook using the entered fields - fields in which you can enter or edit information as opposed to calculated fields.

  1. Run ConceptDraw PROJECT.
  2. Select the command Import in the File menu and choose MS Excel.
  3. Navigate to the folder that contains the file you want to import, select the file in the file list and click Open.

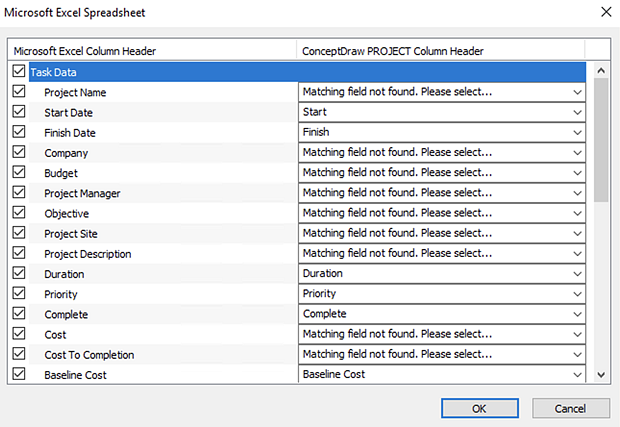

  4. In Microsoft Excel workbook window, select the columns you want to import into your project file and define the appropriate columns of the project schedule. Click OK.

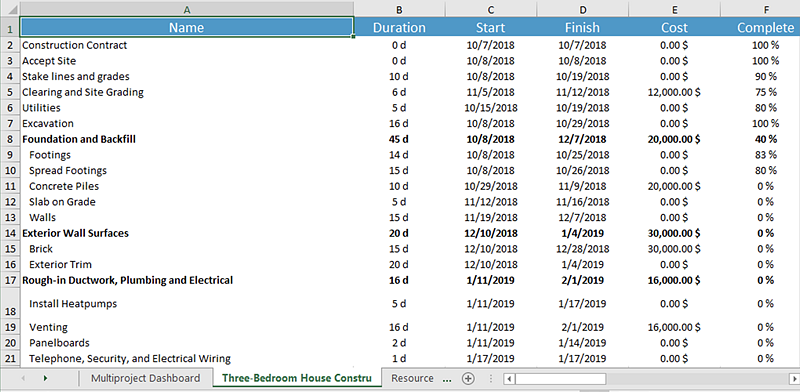

  5. how-to-create-project-from-excel

Typically a source Excel file contains project tasks outline and a list of resources assigned to these tasks. Documents made in MS Excel can be imported into ConceptDraw Project, the following column naming and required information needs to be filled out correctly.

Note: When you create an Excel document, the same naming of columns is prohibited, only the first name will be taken into account, the duplicate column names will be ignored.

Table of ConceptDraw Project and MS Excel columns compliance (Sheet1 — Tasks)

CD Project
Column
MS Excel
Column
Excel Column Format
# # Task number is an optional column. Integer. Should be filled with unique numbers (starting with 1) for proper filling of links in Predecessors. It is allowed to not fill all the task numbers or to not create such a column. In this case, tasks should be written in a row without blank lines. task numbers in links should be names as following: # of order in MS Excel + 1 (shift is due to the headers)
Name Task
Name Task
Task Name
Task name. Line. The column should be named for first-level tasks only. For all further levels, column name is not indicated.
Duration Duration Task Duration. If exists, then represents the number of days added to Start, to get Finish in result.
Priority Priority Task Priority. Integer from 1 to 5. By default : 3.
Start Start Date of task start. Date or Date+Time in MS Excel “Date” format, Or ConceptDraw Project (YYYY-MM-DDThh:mm:ss) format. Do not fill out for phases.
Finish Finish Date of task finish. Date or Date+Time in MS Excel “Date” format, Or ConceptDraw Project (YYYY-MM-DDThh:mm:ss) format. Shouldn’t be filled out for phases. f «Finish Date» is not indicated, it will be calculated based on Start and Duration.
Complete Complete Task Completeness in % Number from 0 to 100. By default: 0.
Deadline Deadline Deadline (date and/or time), by which the task should be completed Date or Date+Time in MS Excel “Date” format, Or ConceptDraw Project (YYYY-MM-DDThh:mm:ss) format. Is empty by default.
Milestone Milestone Milestone in Project Management is a control point, a significant, a key point (for example, switch to a new stage or new phase of work). «Yes» or «No» should be filled with 0 or 1. By default: 0.
Predecessors,
Successors
Predecessors List of Predecessors tasks separated with comma.
Baseline cost Baseline cost Baseline cost. Number. By default: Empty.
Baseline start Baseline start Date or Date+Time in MS Excel “Date” format, Or ConceptDraw Project (YYYY-MM-DDThh:mm:ss) format. By default: Empty.
Baseline finish Baseline finish Date or Date+Time in MS Excel “Date” format, Or ConceptDraw Project (YYYY-MM-DDThh:mm:ss) format. By default: Empty.
Resources Resources
Name Resource
Resource Name
Resource. Line. Resources from the Sheet2 should be entered Column always should be named for the first resource. If there are more resources for this task, then the next columns shouldn't be named. If there is no second sheet with resources, or this section contains a resource that doesn't exist on the second sheet, this resource will be added to the project.
Note Note Line
Hyperlink Hyperlink Line with hyperlink. Column always should be named for the first hyperlink. If there are more hyperlinks for this task, then next columns shouldn't be named.
Outline Level   Outline Level. Calculated based on the column number with name of the task. First-level tasks - in the first column, tasks of the following levels in the following columns with shift.
Outline Number   Outline Number. Calculated based on the column number with name of the task considering order and tasks outline level mentioned on the list above (with smaller numbers).

Table of ConceptDraw Project and MS Excel columns compliance (Sheet2 — Resources)

CD Project
Column
MS Excel
Column
Excel Column Format
# # Integer. Always should be filled out.
Name Resource Name
Resource
Resource Name
Line. Always should be filled out.
Type Type Line. Always should be filled out. The value from ConceptDraw Project resource types.
Cost Cost Number. Always should be filled out. It defines the value of labor costs per hour for the Work type or the value of 1 Material type resource.
Group Group Group name. Optional. Fill out if needed.
E-Mail E-Mail E-Mail. Optional. Fill out if needed.
Notes Notes Line. Optional. Fill out if needed.

Result: MS Excel data will be transferred to a project task list in ConceptDraw PROJECT Gantt Chart view. Resource Sheet in the project will contain a list of resources transferred from the Resources column of the source file. Project will have the same name as Excel spreadsheet. Now you can make a detailed project plan based on primary data from MS Excel workbook.

how-to-create-project-from-excel
How to Import Project Data From MS Excel File

How it works:

  • An extensive variety of reports on project and task statuses
  • Centralizes project information via embedded documents and hyperlinks
  • Managing multiple projects from a single file
  • Powerful integration with other ConceptDraw products

Useful Solution and Products:

Project Management Solutions Area
  • Quickly start a project
  • Plan and execute projects efficiently
  • Visualize different phases of the project using diagrams

Project Exchange
  • Import and export MS Project® files
  • Share your project data with MS Project®, Merlin® and OmniPlan® users
  • Report project status as a mind map

ConceptDraw OFFICE
  • ConceptDraw MINDMAP
    Process, Brainstorming & Thought Organization
  • ConceptDraw PROJECT
    Project & Resource Management
  • ConceptDraw DIAGRAM br> Business Diagramming & Illustration

Products

  • ConceptDraw OFFICE v11
  • ConceptDraw DIAGRAM v18
  • ConceptDraw MINDMAP v16
  • ConceptDraw PROJECT v15
  • ConceptDraw STORE
  • ConceptDraw BOOKS

Solutions

  • Free
  • Premium

Samples

Support

  • Technical Support
  • Upgrade Request
  • Visio File Conversion
  • System Requirements
  • Helpdesk
  • Students & Educators
  • Enterprise
  • Customer Service

Solutions

  • Free
  • Premium

Samples

Video Room

  • Products
  • Solutions

Ready To Buy

  • Buy Online
  • Reseller Partners
  • Manage Your Account
  • Download Your Software
  • CS Odessa

    • About Us
    • Contact Us
    • CS Odessa Identity
    • News
  • CS Odessa
    Plan. Do. Communicate.

    About Us | Contact Us | Feedback | EULA | Privacy | TOU | TOS
    © 1993 — 2025 CS Odessa Corp.
